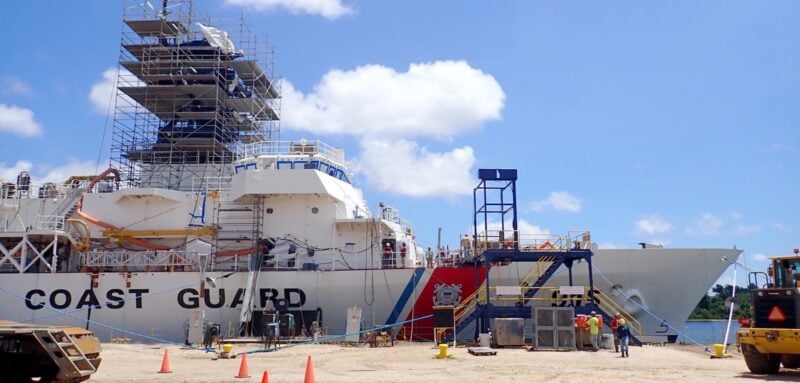

OPC 1 under construction at Eastern Shipbuilding

OPC 1 under construction at Eastern Shipbuilding. Photo courtesy U.S. Coast Guard via GAO

GAO Finds Coast Guard’s Offshore Patrol Cutter Program Mired in Problems

Mike Schuler
Total Views: 7539
November 25, 2025

A new Government Accountability Office report has exposed severe problems plaguing the U.S. Coast Guard’s Offshore Patrol Cutter program, with both shipbuilders failing to deliver any vessels despite years of construction and program costs ballooning to $17.6 billion.

The GAO investigation found that the Coast Guard’s strategy of building ships before completing their designs has proven disastrous. Eastern Shipbuilding Group, the stage 1 contractor, has made minimal progress since GAO’s last assessment, leading the Coast Guard to terminate half of its original four-ship contract in July 2025. The situation deteriorated further when Eastern announced this month that it had suspended work on the remaining two vessels due to “severe financial strain”.

The report states that “construction of OPCs 1-4 began without a stable design, contrary to shipbuilding leading practices,” which “led to rework, which delayed ship deliveries”. OPC 1’s delivery has been pushed back more than five years, from June 2023 to at least late 2026.

Concerningly, the stage 2 contractor Austal USA appears to be following the same troubled path. According to GAO, “construction of OPC 5 began in August 2024 without a stable design.” The report warns that continuing to build additional stage 2 vessels before stabilizing the design “increases the risk that stage 2 will also encounter costly rework and schedule delays”.

The program’s financial picture has deteriorated significantly, with total costs escalating from $12.5 billion to $17.6 billion. GAO found that “the OPC program is at risk of not meeting its cost goals, in part, because the program used outdated cost information to establish them.”

Adding to concerns, GAO discovered weaknesses in Austal’s cost tracking systems that “may be hard to monitor”, making it difficult to assess whether the program is staying within budget as construction progresses.

The Coast Guard faces another challenge with its stage 3 procurement strategy. The program “is unlikely to have results from performance testing of any OPCs before it starts stage 3 procurement activities,” meaning “it could end up buying more ships before knowing if OPCs meets requirements and operational needs.”

GAO issued four recommendations to the Coast Guard and DHS to address these issues, including stabilizing the stage 2 design before authorizing construction of additional vessels, improving cost goal reporting by stage, and developing a comprehensive plan for stage 3 procurement that incorporates testing results and shipbuilding best practices. However, the Department of Homeland Security only concurred with two of the four recommendations.

The troubled program comes as the Coast Guard urgently needs these vessels to replace aging cutters that conduct law enforcement and search and rescue operations. The original plan called for acquiring 25 OPCs across three stages, with stage 1 covering vessels 1-4, stage 2 covering vessels 5-15, and stage 3 covering vessels 16-25.

Despite Eastern Shipbuilding’s challenges with the OPC program, the company secured a $714.5 million contract for hybrid-electric ferries in August, suggesting its difficulties may be specific to the complexity of the Coast Guard vessels rather than general shipbuilding capability.

With Austal USA now holding a $3.3 billion contract for up to 11 OPCs and scheduling its first vessel’s keel laying for December, the question remains whether the Coast Guard and its contractors can learn from past mistakes and deliver the critically needed cutters without repeating the costly errors that have plagued the program’s first stage.
